By Abdullah Al-Mutairi · Published
Kuwaiti citizens allocated a plot in South Sabah Al-Ahmad (جنوب صباح الأحمد) cannot start construction the moment they receive their allocation letter. Building only becomes possible once the Public Authority for Housing Welfare (PAHW) finishes roads, electricity, and water for that specific neighborhood and issues a building-permit certificate, after which the owner applies to Kuwait Municipality for the actual license and can draw on the Kuwait Credit Bank's construction loan.
South Sabah Al-Ahmad is a roughly 6,150-hectare new city about 70 kilometers south of Kuwait City, and most of its numbered neighborhoods are still mid-construction rather than ready for handover. The masterplan, designed with Foster + Partners, lays out more than 11,000 residential units across neighborhoods N1 through N11, alongside schools, mosques, and commercial centers.

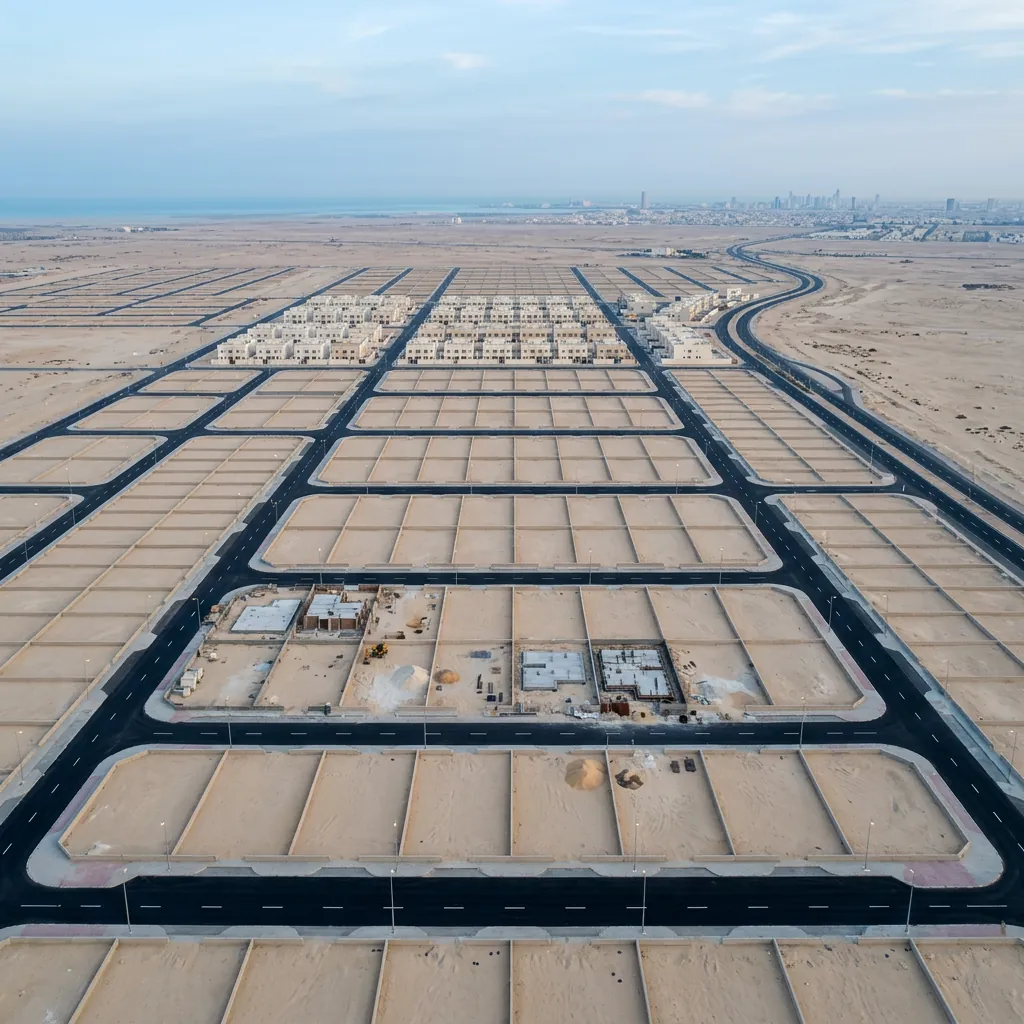

PAHW has already awarded infrastructure contracts worth over $550 million covering roads, water, and electricity networks: one package serves roughly 6,568 units in neighborhoods N1, N2, N3, and N11, and another serves about 7,623 units in N5, N7, N9, and N10. Asphalt paving on the first main roads has begun, and in 2026 PAHW floated its first tenders for neighborhood service centers, a sign that some areas are moving past pure infrastructure into the amenities phase that typically precedes final handover.
Receiving an allocation for one of the قسائم جنوب صباح الأحمد only reserves your parcel; it does not authorize construction. PAHW has to finish roads, electricity, water, and sewage connections for your exact neighborhood before anything else happens.
Once that infrastructure clears a set milestone, PAHW issues each owner a building-permit issuance certificate. This is the same mechanism used at Al-Mutlaa, where more than 27,000 citizens received these certificates once their sections were serviced. Only with that certificate in hand, together with the plot deed, can an owner approach Kuwait Municipality to apply for the formal building license and submit architectural drawings. Starting work before the certificate is issued risks a municipal violation and a demolition order, even on land you have legally been allocated.
Most South Sabah Al-Ahmad neighborhoods are still finishing primary infrastructure, and PAHW's own planning has pointed to its largest-ever plot distribution landing between 2027 and the first quarter of 2028. Owners who received plots in earlier phases should expect handover timed to their specific neighborhood, not a single project-wide date.
This project has slipped before: plans discussed as far back as the late 2000s referenced an earlier priority push, and PAHW currently carries around 100,000 pending housing requests nationwide, with some applicants waiting over 17 years for any allocation at all. Given that history, the safer approach is to follow PAHW's neighborhood-specific announcements rather than general project news, and to treat any date you hear as provisional until your own certificate arrives.
Once licensed, plot owners can apply to the Kuwait Credit Bank (KCB) for a government construction loan capped at KD 70,000, released in stages as the build progresses rather than as a lump sum. The first disbursement is tied to the start of work and foundation casting, with later tranches following municipal inspection of progress.
Eligibility is limited to Kuwaiti citizens entitled to housing welfare, and the loan amount is reduced by the value of any land PAHW has already allocated to you. Divorced or widowed Kuwaiti women building on their own plot qualify for the same KD 70,000 cap, though loans for expanding an existing home are capped lower, at KD 35,000. Lining up a licensed contractor and engineering office before your first disbursement helps avoid delays between loan stages.
Many plot recipients keep renting near their current job or school while they wait, rather than assuming construction will start on the date first announced. South Sabah Al-Ahmad sits within the southern expansion of Ahmadi governorate, near Sabah Al-Ahmad Sea City, so owners comparing nearby costs can browse properties for rent in Ahmadi governorate or properties for sale in Ahmadi governorate to track how the surrounding market is moving.
Some owners also weigh buying private land instead of waiting on a government allocation; checking current land plots for sale in Kuwait gives a useful benchmark against the KD 70,000 KCB loan cap. For a broader read on where prices and rents stand nationally, the full properties for sale in Kuwait and properties for rent in Kuwait listings are worth a periodic check while your plot's infrastructure is completed.
Can I sell my South Sabah Al-Ahmad plot before building on it?
Government-allocated plots generally cannot be freely resold on the open market before a title deed is issued, since the allocation is a housing-welfare right rather than a fully transferable asset at that stage. Any attempt to transfer an allocation informally risks losing it altogether. Confirm the current resale and transfer conditions directly with PAHW before agreeing to anything with another party.
What happens if I don't build within the required timeframe?
PAHW and Kuwait Municipality can reclaim plots left undeveloped past the deadline set at allocation, since the program exists to house citizens rather than hold vacant land indefinitely. If delays are caused by infrastructure that hasn't reached your neighborhood yet, request a written extension or confirmation letter from PAHW rather than letting the deadline lapse without documentation.
Is South Sabah Al-Ahmad part of Ahmadi governorate?
Yes. The project sits in the southern expansion zone near Sabah Al-Ahmad Sea City, within Ahmadi governorate, alongside established areas such as Wafra and Khairan. That places future residents close to the governorate's industrial and port employment zones, which is part of why PAHW has prioritized road links back toward Kuwait City and the airport.
Can I use a private bank mortgage instead of the Kuwait Credit Bank loan?
Not yet in practice. Kuwait Credit Bank remains the main government channel financing construction on an allocated plot, with loans capped at KD 70,000 paid in stages. A separate real estate financing law that would let commercial banks offer long-term mortgages has been under discussion, but owners building today should plan around the existing KCB loan rather than assume private mortgage financing is available.
How many housing units will South Sabah Al-Ahmad eventually include?
The masterplan, developed with Foster + Partners, outlines more than 11,000 residential units across numbered neighborhoods, plus roads, schools, mosques, and service centers whose first tenders were only floated in 2026. Infrastructure and handover proceed neighborhood by neighborhood rather than all at once, so the number of plots cleared for construction grows gradually rather than in a single release.
